← Back to projects

HardDriverz

Lead Producer · 54-person team · Jan–May 2025 · SMU Guildhall GameLab

A 3D arcade racing game in Unreal Engine 5. Players customize karts to compete through twisty, futuristic tracks that defy gravity, picking up power-ups to outpace rivals.

Free on Steam. Watch the trailer below.

HardDriverz key art
54Devs led
100sBugs triaged
4Milestone delivery docs
5Months Pre-Pro to Launch

Led a 54-person team to Steam launch

Designers, artists, engineers, audio. Cleared blockers across disciplines, kept the Jira backlog honest.

Owned end-to-end Steam release pipeline

Coordinated build deployment, milestone delivery, stakeholder sign-off through to publication on Steamworks.

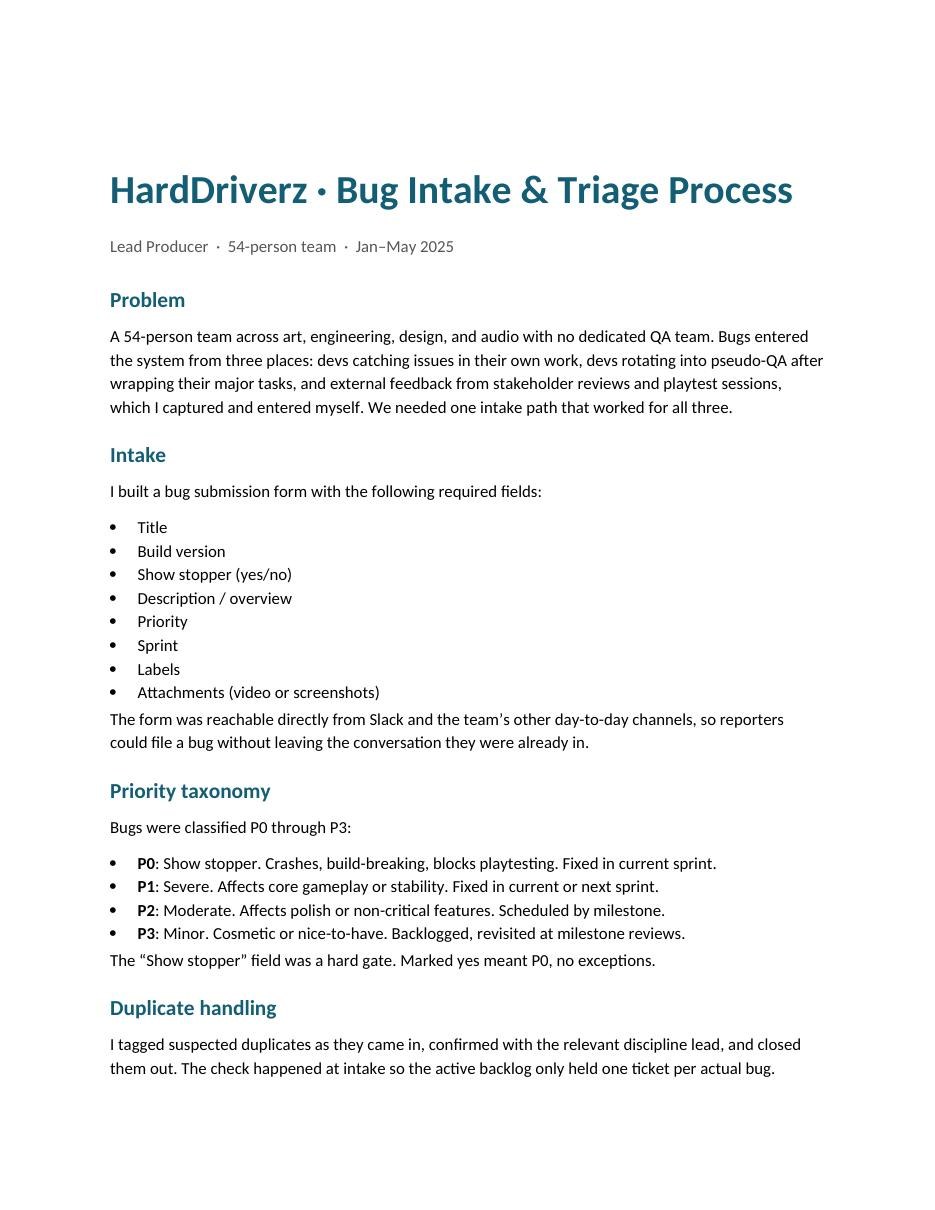

Engineered bug-tracking workflows

Processed hundreds of bugs through structured intake. Cut duplicates significantly and improved cross-team visibility.

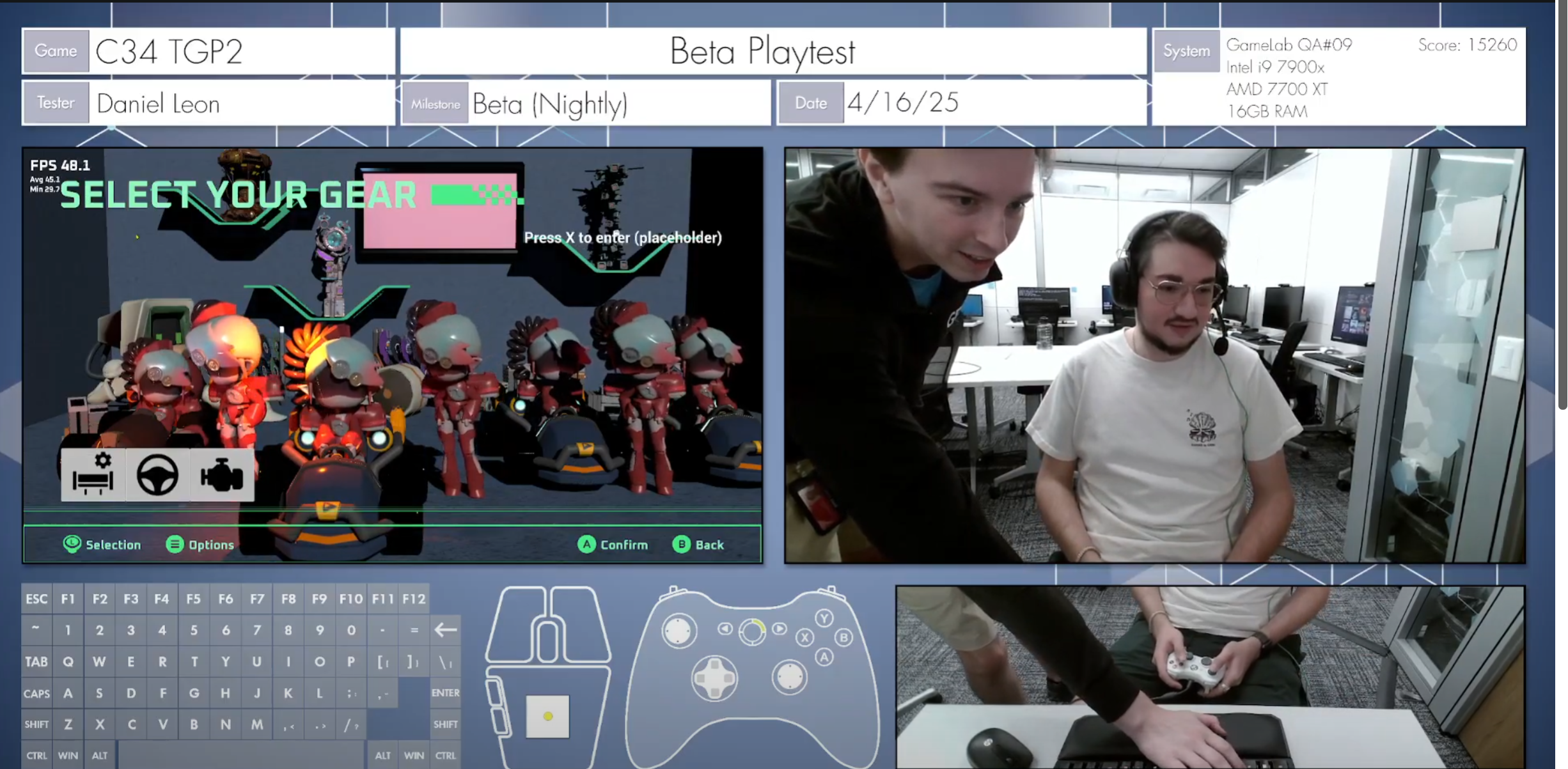

Optimized Jira boards and dashboards

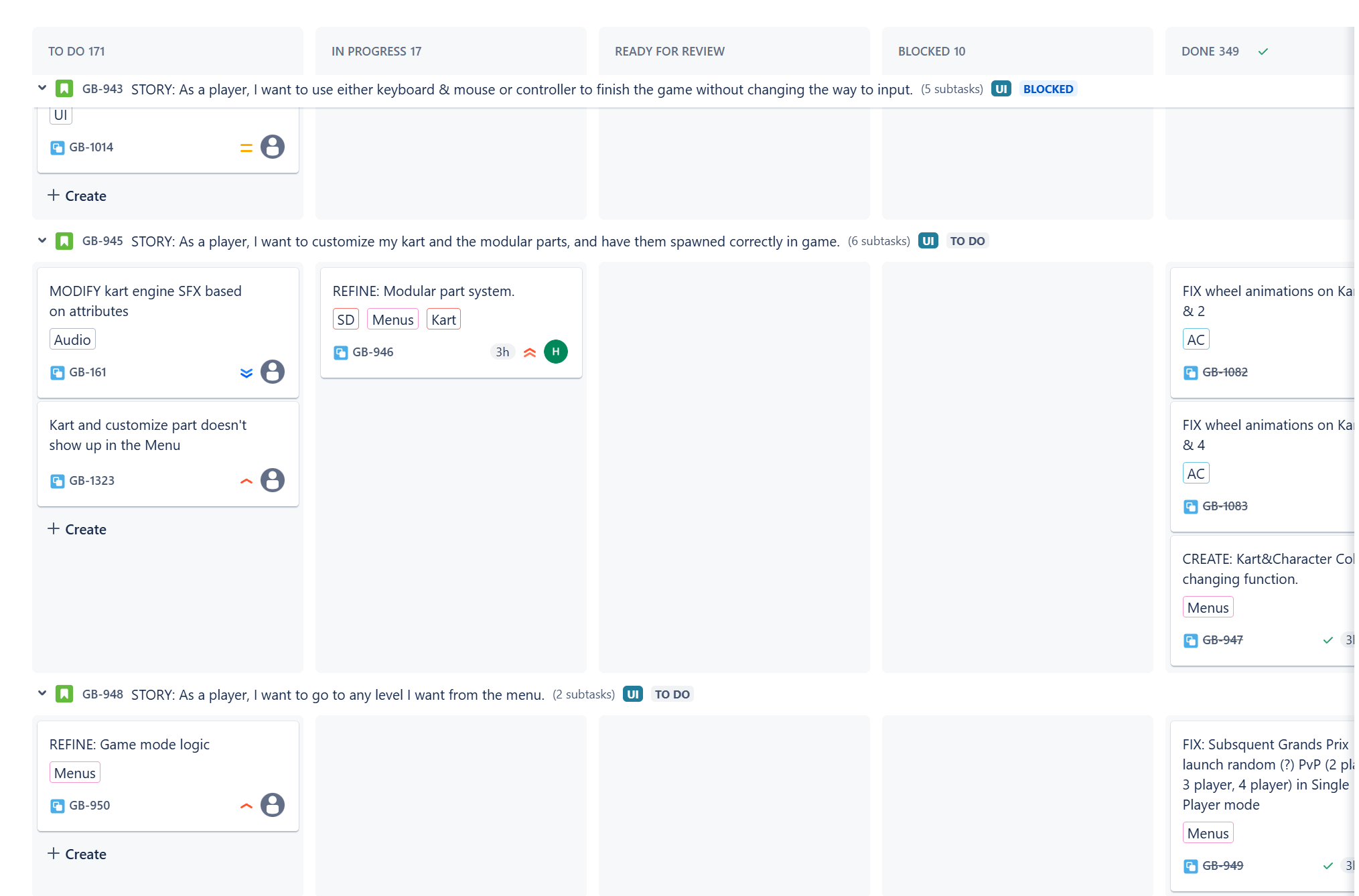

Organized backlogs and filters so leads could see task and user story progress at a glance without producer intervention.

Scoped project work, aligned vision

Sat with engineering and design leads to scope features into things they could ship within a full milestone cycle.

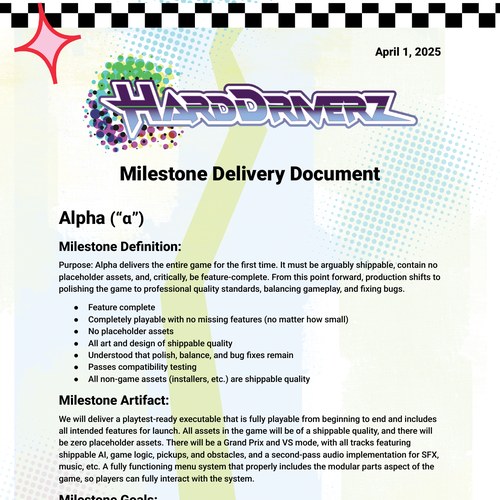

Wrote milestone delivery docs

One per milestone, used in stakeholder reviews. Covered scope, dependencies, risks, and cuts.

Jira Confluence Perforce Unreal Engine 5 Microsoft Office Slack OBS Steamworks
  1. Ask the right questions to get to the underlying issues. Early in development we treated a stakeholder-recommended tool as a silver bullet for the menu system. Focusing on immediate symptoms obscured deeper technical challenges, like splitscreen functionality, that became major blockers later. Identifying hidden concerns early avoids costly setbacks.
  2. Managing a product backlog. First opportunity to work in Jira and take ownership of developing a full backlog. Grew in writing user stories, defining conditions of satisfaction, and bug reporting. Took over backlog grooming each sprint and supported leads by reviewing their tasks.
  3. Building trust with communication and positivity. Leading 54 developers and interfacing with stakeholders was a formative challenge. Daily morning announcements and Scrum of Scrums kept alignment. A lead producer's attitude is contagious — staying positive and composed helped the team maintain morale through demanding milestones.
  4. How to create a sprint schedule and milestone delivery document. Underestimating the difficulty of consolidating multidisciplinary work into a build led to high-stress, down-to-the-wire deadlines. Sprint calendars that accounted for downstream dependencies significantly reduced stress. Clear milestone delivery docs reinforced transparency with stakeholders.
